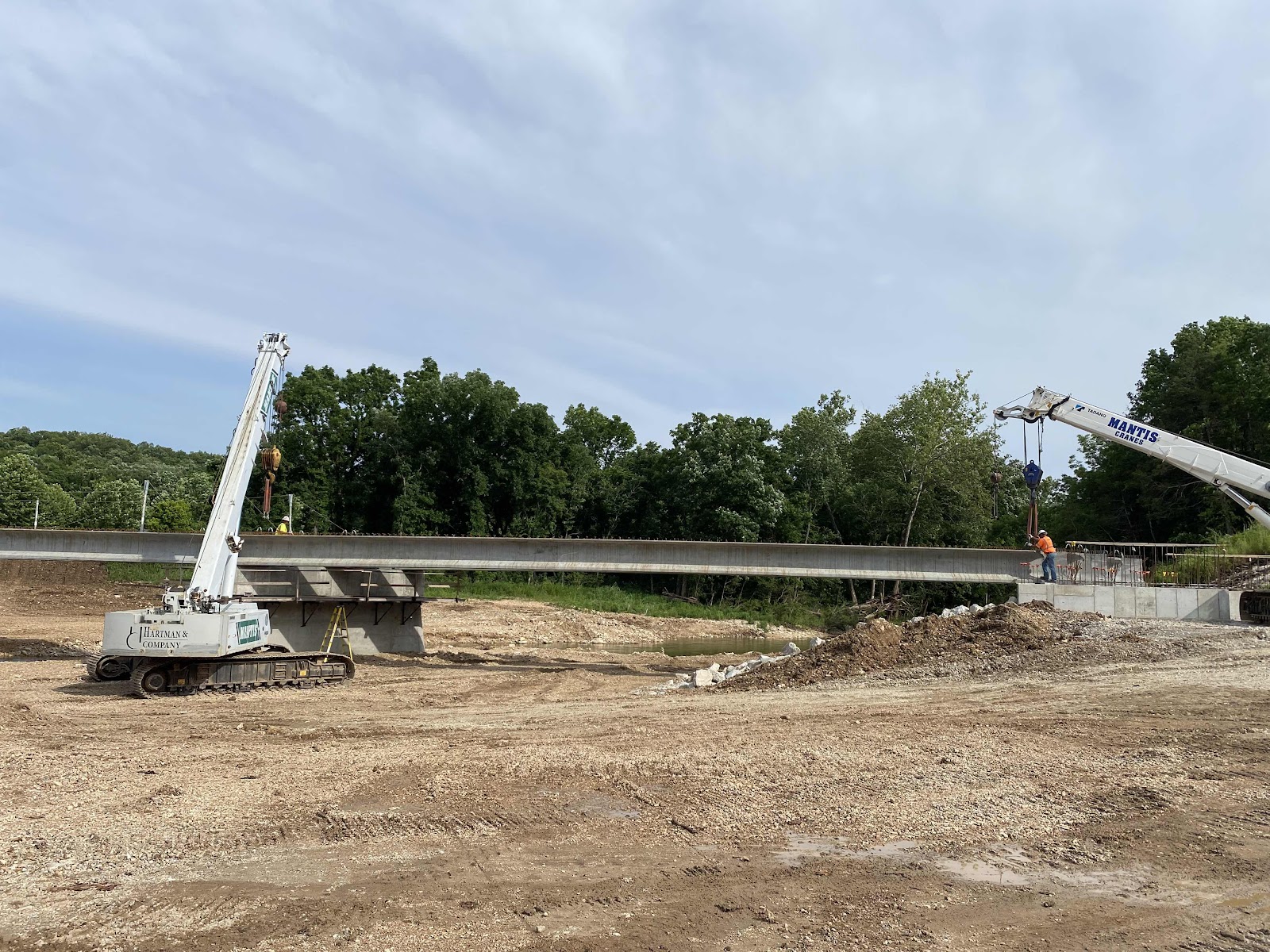

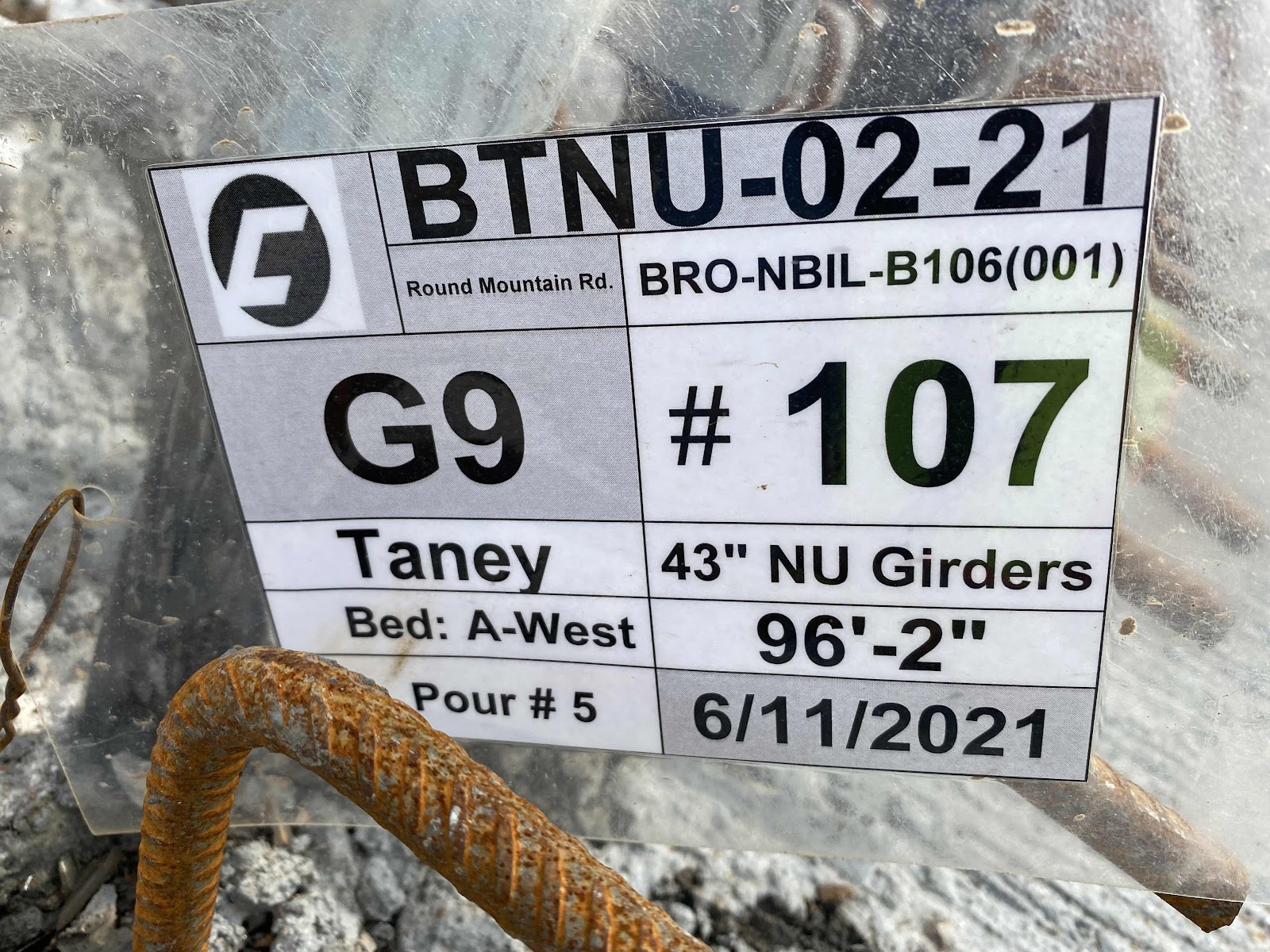

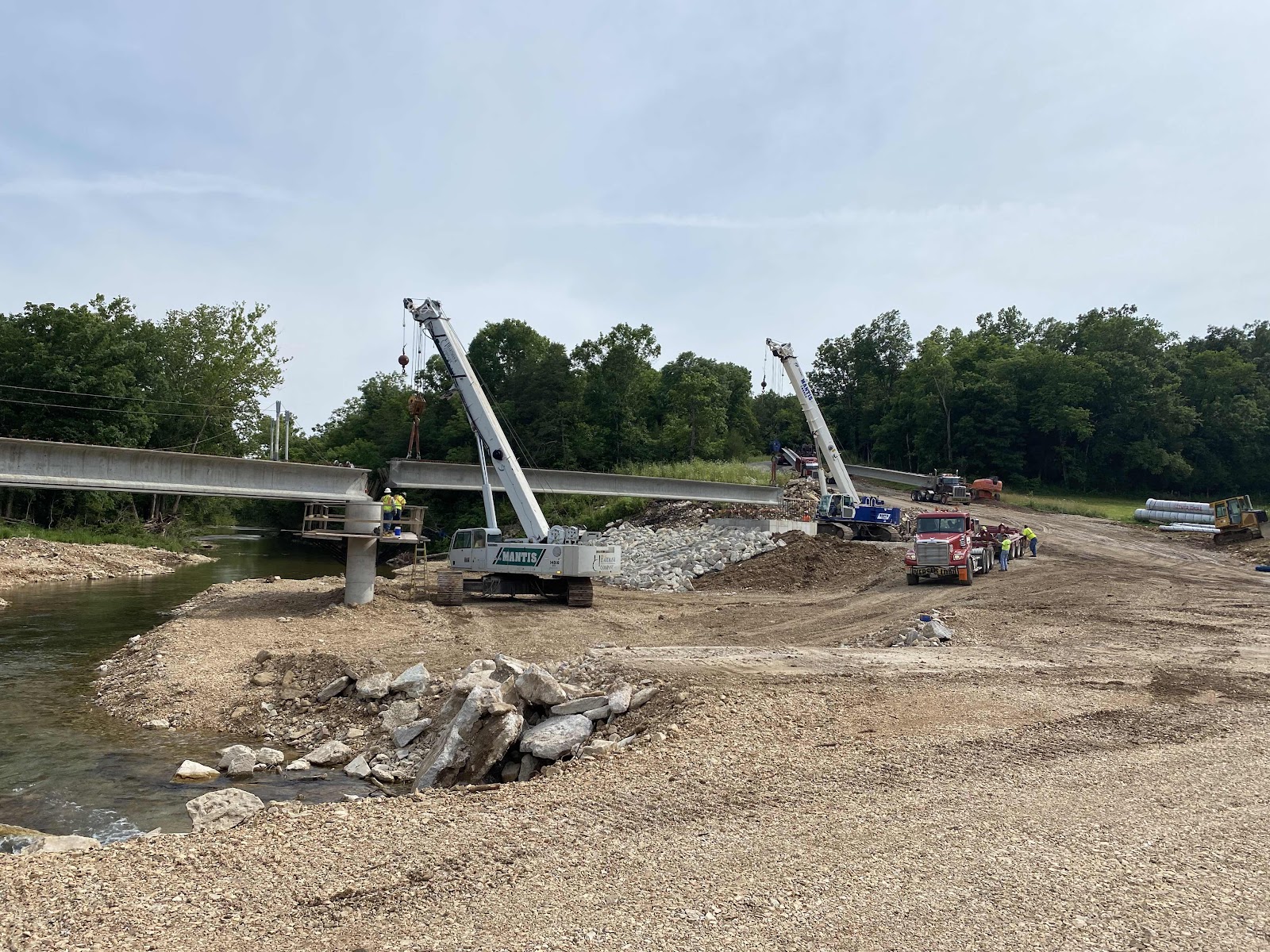

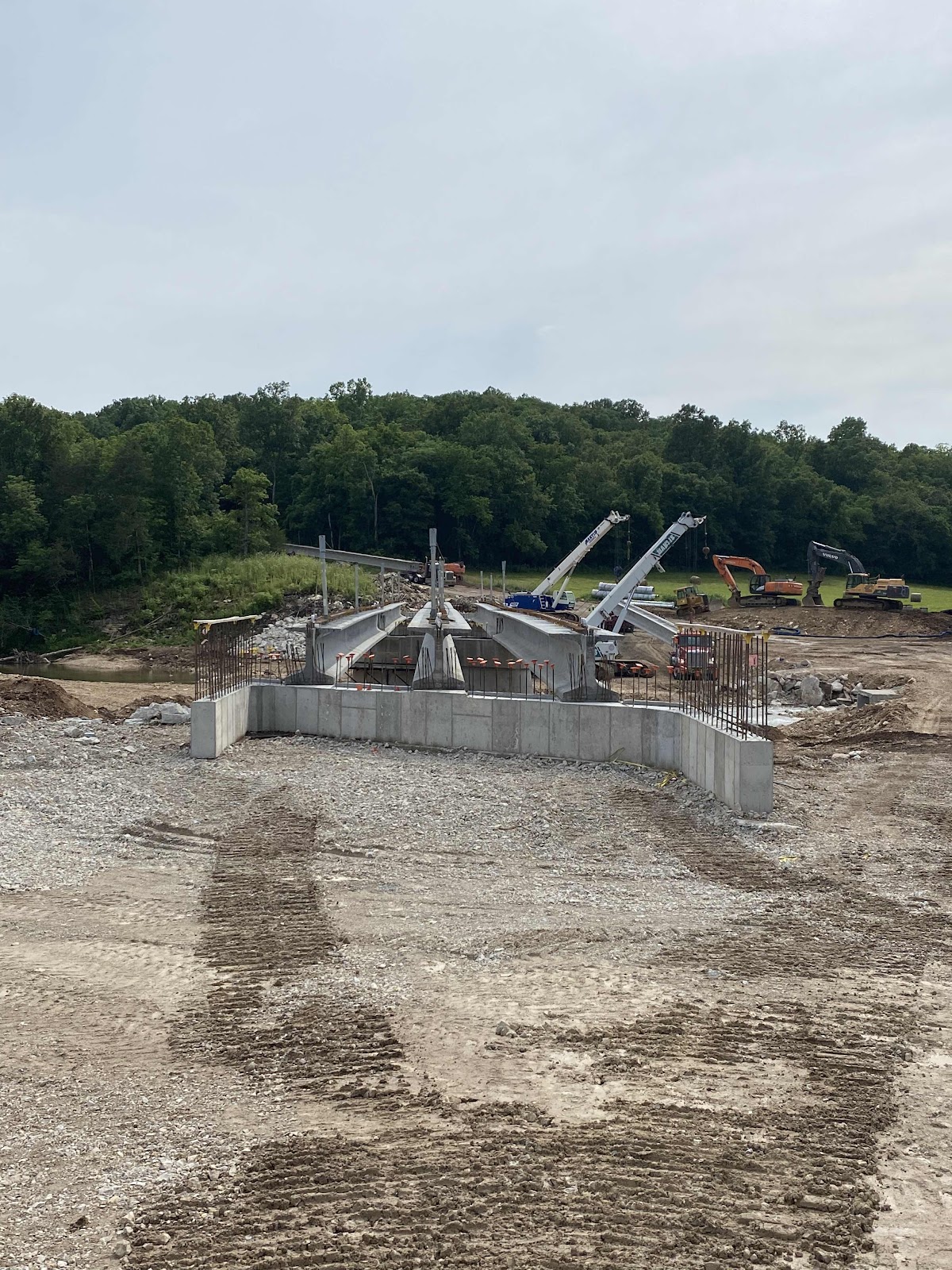

Cranes are set up and ready for girders. Girders have arrived on site. First one being set into place. On the third girder. 5 total delivered today. Setting the final one for the day. 5 completed. Remaining will be delivered next week.
Equipment delivery. Finishing up removing the forms from the box culvert. Work slab in around the piling for end bent 4. CMP delivered. Work slab in around the piling for end bent 1.
North side of the box culvert has the rebar complete. Will begin setting forms up. South side rebar is being installed by Realm Construction. Tearing out the existing crossing. A lot of busted up concrete being hauled off. Forms being set up as the rebar install is complete.
